Hawaiʻi Act 125 · Kauaʻi Pillar Guide

Kauaʻi Cesspool Conversion & Act 125 Compliance

Everything Kauaʻi homeowners need to plan a compliant, cost-controlled cesspool conversion, deadlines, system options, permits, pricing, and how to start.

Roughly 14,000 cesspools remain in service across Kauaʻi County, the highest density of any Hawaiian island. Under Hawaiʻi Act 125 (HRS 342D-72), every one of them must be upgraded, converted, or connected to sewer before January 1, 2050. The Hawaiʻi DOH also publishes planning-urgency categories so homeowners and agencies can decide where to convert first. This guide covers what Act 125 actually requires, the four Individual Wastewater System (IWS) options under Hawaiʻi DOH, the Kauaʻi permit timeline, 2026 cost inputs, and how to get a free site-specific assessment from a Kauaʻi crew.

The 2050 Statewide Deadline and DOH Planning Categories

January 1, 2050 is the only enacted statewide cesspool deadline under Act 125 (HRS 342D-72). Alongside that deadline, Hawaiʻi DOH publishes a Cesspool Hazard Assessment and Prioritization Tool that groups systems into planning-urgency categories to help homeowners and agencies decide where to convert first. Those categories are not legal deadlines for individual properties.

Aerial view of Kauaʻi, Hawaiʻi. Forested island surrounded by deep Pacific ocean.
Kauaʻi, Hawaiʻi
Plan ahead of the 2050 statewide deadline
Kauaʻi cesspool planning-urgency categories under Hawaiʻi Act 125 (statewide January 1, 2050 deadline)Accurate coastline of Kauaʻi with major towns marked and shaded by Hawaiʻi DOH planning-urgency category: Priority 1 (plan first, typically shoreline and drinking-water zones) and Priority 2 (plan early, typically inland high-density zones). These categories are planning guidance, not legal deadlines. The only enacted statewide deadline is January 1, 2050.NHANALEIPRIORITY 1 · PLAN FIRSTKĪLAUEAPRIORITY 1 · PLAN FIRSTKAPAʻAPRIORITY 2 · PLAN EARLYLĪHUʻEPRIORITY 2 · PLAN EARLYPOʻIPŪPRIORITY 1 · PLAN FIRSTWAIMEAPRIORITY 1 · PLAN FIRST
  • Priority 1: Plan First
    Planning urgency (not a legal deadline). Typically shoreline, stream, or drinking-water zones.
  • Priority 2: Plan Early
    Planning urgency (not a legal deadline). Typically high-density or impaired watershed.
  • 2050 Statewide Deadline
    Every Hawaiʻi cesspool must be converted, upgraded, or connected to sewer by January 1, 2050 under Act 125.
Fig. 2. Kauaʻi cesspool planning-urgency categories under Hawaiʻi Act 125. Priority 1 and Priority 2 are planning guidance from the DOH prioritization tool, not legal deadlines. The only enacted statewide deadline is January 1, 2050. Confirm your parcel's category with the Hawaiʻi Cesspool Prioritization Tool or the DOH Wastewater Branch.

Priority 1: Plan First

A planning-urgency category, not a legal deadline. Priority 1 typically includes cesspools closer to shorelines, perennial streams, wetlands, or drinking-water sources. To confirm the category for your parcel, use the Hawaiʻi Cesspool Prioritization Tool or contact the DOH Wastewater Branch.

Priority 2: Plan Early

A planning-urgency category, not a legal deadline. Priority 2 typically includes high-density residential zones and parcels in the broader watershed of impaired surface waters. To confirm the category for your parcel, use the Hawaiʻi Cesspool Prioritization Tool.

2050 Statewide Deadline

Under Act 125 and HRS 342D-72, every cesspool in the State of Hawaiʻi must be upgraded, converted to septic or IWS, or connected to sewer by January 1, 2050. This is the enacted, binding date.

The 4 IWS Options Under Hawaiʻi DOH

"IWS" (Individual Wastewater System) is DOH's umbrella term for any on-site wastewater treatment system that is not a cesspool and not connected to municipal sewer. Four configurations are permitted on Kauaʻi. Your percolation test, soil profile, lot slope, and depth to groundwater determine which one DOH will permit for your address.

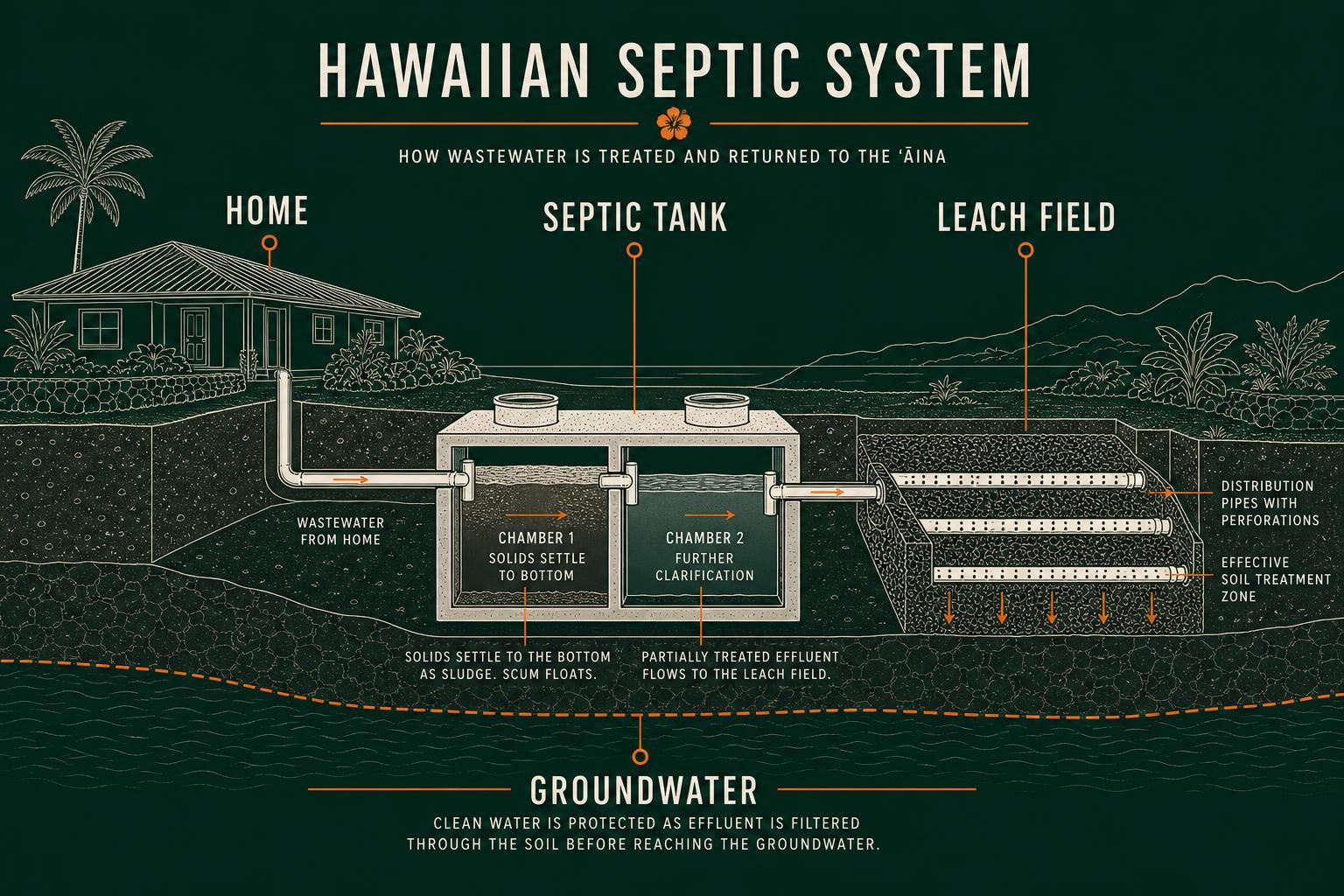

Editorial cutaway diagram of a Kauaʻi cesspool-to-IWS septic conversion: home, two-chamber septic tank, and leach field above the groundwater table
Home

Wastewater from every fixture leaves the house through a single gravity waste line.

Septic Tank

Two chambers let solids settle and scum float. Clarified effluent flows out the second chamber.

Leach Field

Perforated pipes disperse effluent through soil, DOH requires a minimum 3 ft to groundwater.

Fig. 1, Cesspool-to-IWS septic system cross-section on Kauaʻi. Adapted from Hawaiʻi DOH CCWG Cesspool Conversion Technologies Report (2024).

1. Conventional Gravity Septic

A septic tank separates solids and floats grease; effluent flows by gravity to a buried leach field where soil bacteria finish treatment. Best for lots with good percolation (15 to 60 minutes per inch), adequate slope, and standard setbacks.

2. Aerobic Treatment Unit (ATU)

A septic tank with active aeration that grows treatment bacteria fast and discharges much cleaner effluent. The leach field is smaller because the water leaving the tank is mostly treated. Required by DOH on many shoreline parcels. Requires an annual service contract.

3. Drip Dispersal

Treated effluent is pressure-distributed through small-diameter drip tubing across a shallow field, like slow drip irrigation. Best for shallow soil over rock (common on South Shore Kauaʻi), steep slopes, or properties where preserving landscape matters.

4. Elevated (Mound) System

When native soil cannot accept effluent (high groundwater, hardpan, or shallow rock), an engineered sand-and-gravel mound is built above grade to serve as the treatment medium. Common on Hanalei and Wailua floodplain parcels.

For the excavation, trenching, and tank-set side of any of these, see septic installation on Kauaʻi.

Permit Process and Timeline

Cesspool conversion on Kauaʻi crosses three desks: an engineer for the system design, DOH Wastewater Branch for the IWS permit, and your contractor for the installation. A realistic end-to-end timeline:

First callOperational system
  1. Site Assessment

    TMK check + priority tier confirmed

  2. Perc Test

    Soil percolation measured on-site

  3. Engineered Design

    Engineer stamps the plan

  4. DOH Permit

    Wastewater Branch reviews + approves

  5. Install

    Excavation, tank set, leach field

  6. Inspection

    Final walk-through + backfill

Fig. 3, Kauaʻi cesspool conversion process, first call to operational IWS. Adapted from Hawaiʻi DOH CCWG Cesspool Conversion Technologies Report (2024).
  • Week 1 to 2: Site assessment, TMK and DOH category check, percolation testing scheduled.
  • Week 3 to 6: Percolation test results returned; engineered IWS design completed.
  • After design: DOH Wastewater Branch permit application submitted.
  • After submittal: DOH review could take up to several weeks.
  • Construction window: a few days from break-ground to inspected and backfilled.
  • Plan several weeks from first call to operational system. Start earlier if your parcel is in a Priority 1 category.

What Goes Into Your Conversion Estimate

Every Kauaʻi property is different. Soil conditions, slope, access, distance to the leach field, rock content, and the permitted system type all change the scope of work, which means we cannot honestly quote your conversion until we have walked your property.

What we promise:

  • A free on-site assessment with no obligation.
  • A clear, itemized written proposal within a few business days.
  • Transparent line items so you can see exactly what you are paying for.
  • No surprise change orders. If conditions change underground, we talk to you before we touch a thing.

Call (808) 855-DIRT to schedule your free site assessment.

Why Plan Ahead Instead of Waiting

Property sale

Title companies and lenders are increasingly flagging non-compliant cesspools at closing. Several Kauaʻi sales in 2025 stalled at the cesspool disclosure step. Converting before listing protects your sale price and your closing timeline.

Insurance

More homeowner-insurance carriers are starting to ask about wastewater system type on new policies and renewals, especially for coastal property. A new IWS is a better risk story than a legacy cesspool.

Permit queue and contractor availability

DOH Wastewater Branch review times are already lengthening as the 2050 statewide deadline approaches. Kauaʻi has a finite pool of IWS installers, and the months before that deadline are likely to see waitlists and rush-job premiums. The cheapest conversion is the one planned years in advance.

Grants and financing

The Kauaʻi County Residential Cesspool Conversion Grant Program closed September 27, 2024, and the State of Hawaiʻi cesspool conversion income tax credit has expired. We track program status on our grants and tax credits page. If financing is a concern, we can point you toward private lending resources we work with during your site assessment.

Cesspool Conversion Across Kauaʻi

We run cesspool conversions across every Kauaʻi town. Each parcel has its own soil, percolation, and access story, start with your town below.

Frequently Asked Questions

Free On-Site Cesspool Assessment

We'll check your priority tier, review the access and soil story for your lot, and tell you which IWS options DOH is likely to approve, before you spend a dollar on testing.
